Trigger Events and the Replication Trap

Acquisitions, audits and fixed go-live dates force ITSM migrations. Four client cases show how to redesign the service and leave old workarounds behind.

An old request form covered in sticky-note workarounds, a calendar with one date marked in red, and the new platform's form copied field for field, the same sticky notes now in red.
Listen to this article

Part of a series. This article is drawn from the L5 whitepaper on modernizing IT service management, and looks at the moment a platform change is forced. Download Modernizing IT Service Management.

An ITSM migration usually happens because something forces the decision: a company is bought or carved out, a license ends, an audit raises a finding, or the business sets a go-live date. The months after that event are a rare chance to redesign the service, looking hard at each field, form, rule and report you inherited and deciding whether to keep, simplify, replace or retire it. A common mistake, which this article calls the replication trap, is to rebuild the old configuration on the new platform along with its workarounds.

In the conversations behind this article, the move was forced in exactly this way: a carve-out with a transition services agreement running out, a run of acquisitions, an outdated change tool that no longer met audit needs, and a legacy license ending on a fixed date. Four of those stories follow, after a look at why the timing matters and why copying is so tempting.

When is an ITSM platform easiest to redesign?

An ITSM platform is easiest to redesign around its launch. When Tyre and Orlikowski studied how organizations adapt new technology, they found that people did most of their adapting in a short window soon after the technology went into use. After that, people settled into routines, and little changed until a surprise or a new discovery set it off again.

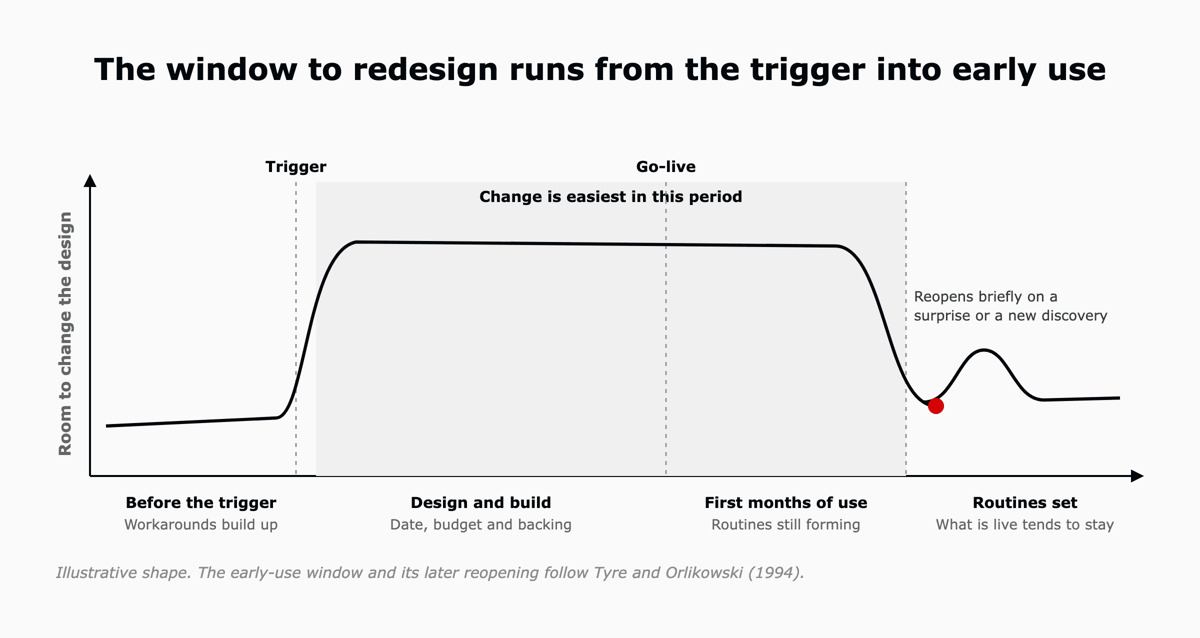

An illustrative curve of room to change the design: low before the trigger, high from the trigger through design and build and the first months of use, then low once routines set, reopening briefly on a surprise or a new discovery.
The window to redesign runs from the trigger into the first months of use.

A trigger event opens that window early. It brings a date, a budget and senior backing, so the design work can start before go-live, and whatever is live when the routines settle is usually what stays. The time available is shorter than it looks.

PwC puts the typical exit from a transition services agreement (TSA), the period in which a carved-out business keeps using its former parent's systems, at 12 to 24 months, and counts more than 1,500 design decisions in a typical exit. Faced with that many decisions and a fixed end date, copying the existing setup can feel like the only safe plan.

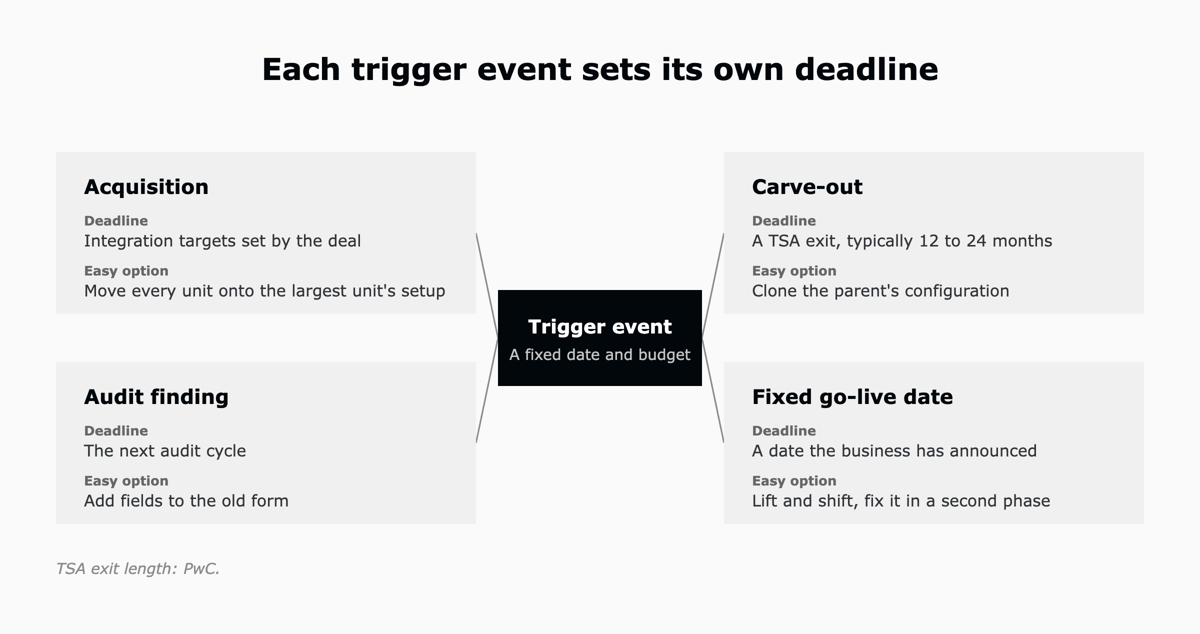

Four trigger events and the deadline and easy option each brings: an acquisition, a carve-out with a TSA exit of typically 12 to 24 months, an audit finding, and a fixed go-live date.
Each trigger event sets its own deadline, and each comes with an easy option to copy.

Why do migrations copy the old configuration?

Teams copy the old configuration because it is the easiest plan to write down and test, and few people will argue with it when the date is close. Saritasa's 2025 survey of US IT professionals found the same instinct: among the 299 respondents whose organizations still run legacy systems, the most-cited reason for not modernizing, given by half of them, was that the current system still works.

Decision research helps explain the instinct. Samuelson and Zeckhauser showed that people lean toward keeping things as they are, and Norton, Mochon and Ariely found that people place a higher value on things they have built themselves. If you have looked after a configuration for years, both apply to you.

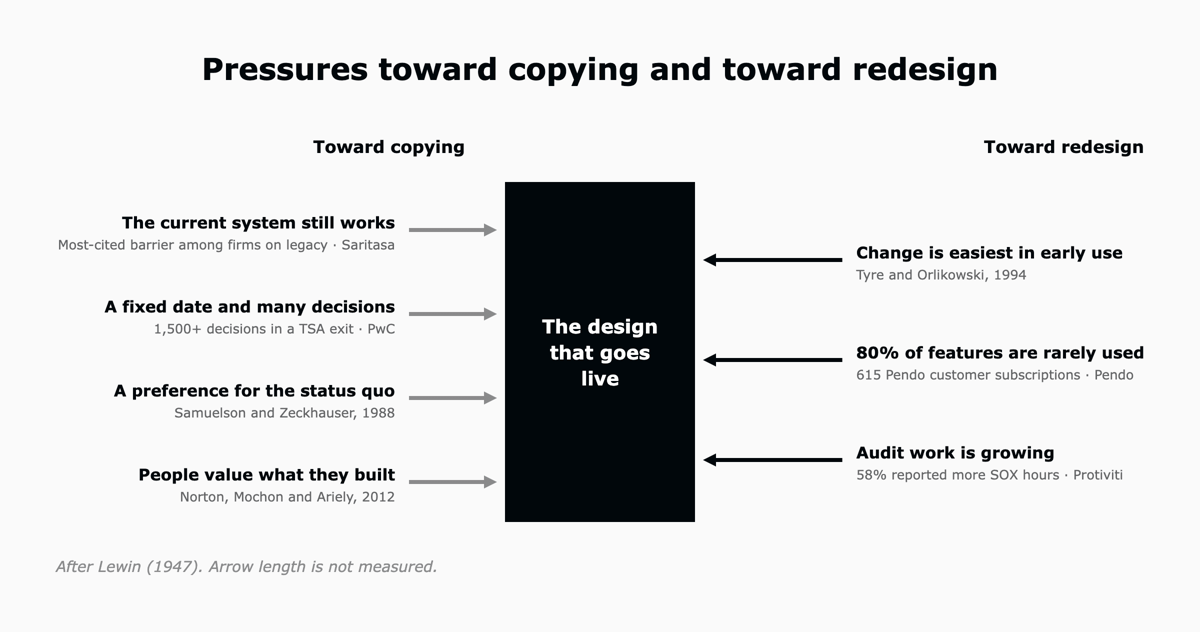

A force-field diagram after Lewin. Pressures toward copying: the current system still works, a fixed date and many decisions, a preference for the status quo, and people valuing what they built. Pressures toward redesign: change is easiest in early use, 80% of features are rarely used, and audit work is growing.
A force-field view after Lewin, drawn from the research cited. Arrow length is not measured.

The trouble is that the old configuration makes a poor specification. Thoughtworks put legacy migration feature parity on Hold in its Technology Radar in 2019 and 2020 and called it an antipattern, pointing out that older systems often carry many features their users no longer touch. Pendo's data points the same way: across 615 of its customers' software subscriptions, 80 percent of features in the average product were rarely or never used.

Rebuilding those features also adds work to projects that tend to overrun already. Ensono reports that 71 percent of modernization initiatives have exceeded planned costs. Here is how the two approaches differ for five common elements.

ElementCopiedRedesigned
Fields and formsRebuilt as they wereKept where usage data shows people use them
ApprovalsCopied step for stepMatched to the risk of the request
Change typesAs the old tool defined themStandard, normal and emergency, as in ITIL
Undocumented rulesRebuilt without anyone writing them downWritten down first, then kept or retired
Acceptance testThe new platform does what the old one didThe platform meets its agreed service levels and audit controls

What did organizations do with their trigger events?

Each of the organizations below had a deadline and an easy option to copy what it already ran. Two are L5 clients, and two were prospects we were scoping.

Case A: acquisitions in chemicals

This chemicals company was partway through three acquisitions, and the businesses it was bringing together ran on different service tools, one of them an enterprise ITSM platform. In its own words, "it's all fragmented." The obvious move is to pick the biggest unit's tool and move the others onto its configuration, workarounds included.

Our recommendation in a case like this is to agree how the combined company should run service before choosing any tool, with one set of request types, priorities and change types for the whole group. Once that model exists, the platform configuration follows from it, and picking the tool becomes a smaller decision that can come later.

Case B: a carve-out in healthcare

When this healthcare business was carved out of a larger group, it kept running on the parent's ITSM platform under a TSA with a fixed end date, and HR and the other employee services had no central place to manage cases. Cloning the parent's setup would have been the quickest way to meet the exit date. We proposed designing for the company it is becoming, with fewer groups, simpler routing and one way of managing cases across employee services.

Case C: an outdated change tool in financial services

This financial services client ran change management on an outdated tool, and who got assigned a change was, in the team's words, "fully tribal knowledge."

Audit needs shaped the new design, and the team was clear about what it did not want from the new form: "What we don't want to do … is create it so that it takes you 45 minutes to generate the change request in order to … build a USB flash drive."

We simplified the process around the three change types in ITIL change enablement. Standard changes are low risk and pre-authorized, normal changes are assessed and authorized, and emergency changes are expedited. ITIL Version 5, released in 2026, keeps all 34 ITIL practices, change enablement among them.

In the new design, routine work needs no change board, approvals are recorded in the ticket, and a record locks once it is approved. The client began with a three-week pilot before retiring anything.

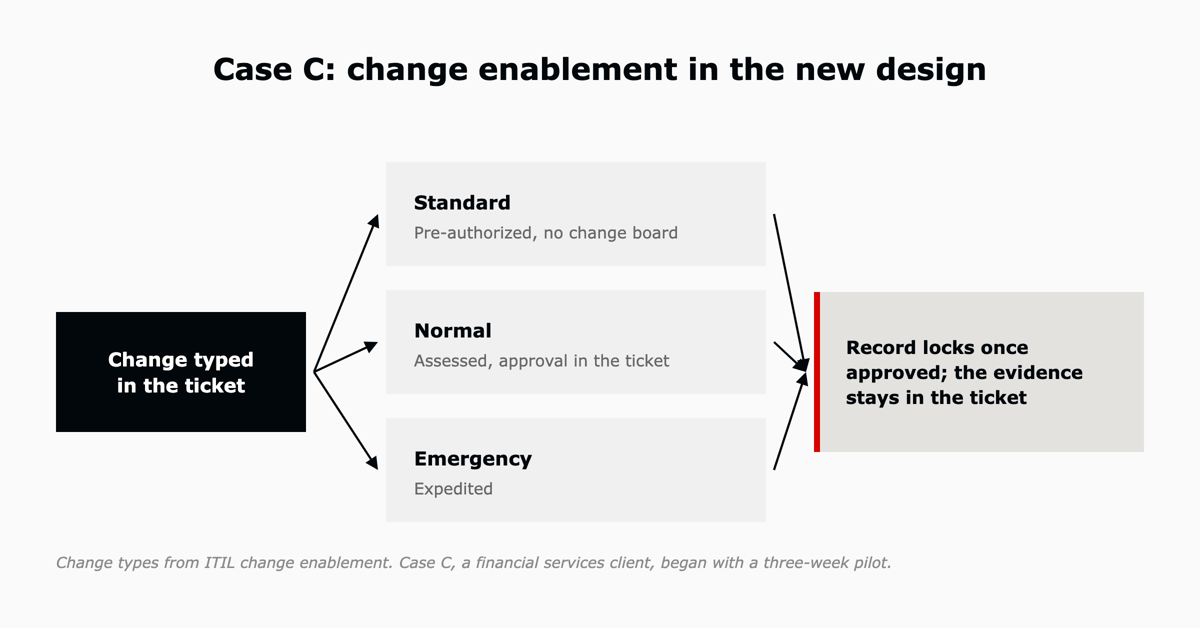

The new change design in Case C: a change typed in the ticket as standard, normal or emergency, with the record locking once approved so the evidence stays in the ticket.
Case C: change enablement in the new design, using the ITIL change types.

Case D: a license end date in media

This media client was moving off an email-based legacy system, and the deadline was fixed: the old vendor's licenses had to come out by April. Its IT lead summed up the tension inside the team: "They want a new coat of paint. They don't want someone to come in and take walls down. I think that fundamentally we need to take some walls down."

Our approach in a case like this is to keep the date and cut the scope, with fewer steps and a short list of request types, and to plan improvement work to carry on after launch so it does not depend on someone funding a second phase.

What did the cases have in common?

The pressure to copy looked much the same across the cases. The table shows where each pattern came up and what we put in its place.

PatternCasesWhat replaced itEvidence
The old tool used as the specificationC, DAcceptance against agreed service levels and audit controlsFeature parity is on Hold in the Thoughtworks Technology Radar
The deadline used as the design authorityB, DA reduced scope at the same date, live in phasesA typical TSA exit involves more than 1,500 design decisions
One unit's setup used as the defaultA, BOne service model for the organization as it is nowAdaptation clusters soon after a system goes into use
Undocumented rulesCRules written down first, then kept or retiredChange assignment was "fully tribal knowledge"

Sometimes the right decision is to keep what you have: Ensono reports that 52 percent of organizations are optimizing and extending existing systems, and our guide to legacy systems and AI sets out when to retain, augment or replace.

How should the next trigger event be used?

You can usually see the next trigger coming, whether it is a contract renewal, an acquisition or the next audit cycle. That gives you time to start the first two steps before it arrives, and the last step carries on after go-live.

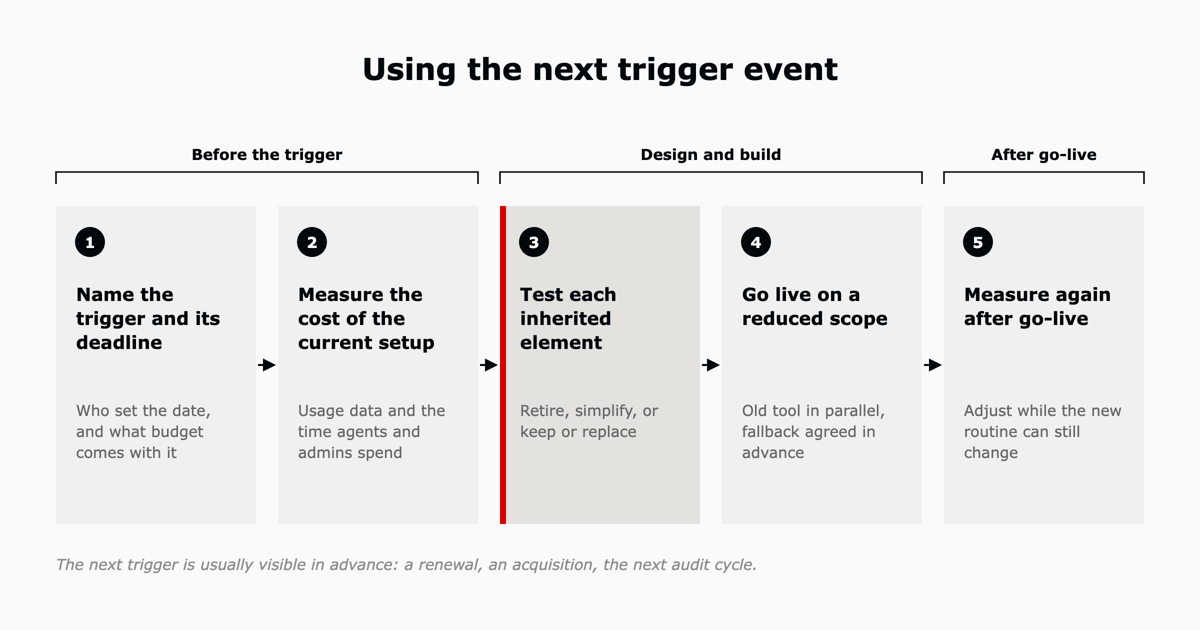

Five steps grouped by when they happen: name the trigger and its deadline and measure the cost of the current setup before the trigger; test each inherited element and go live on a reduced scope during design and build; measure again after go-live.
The steps in order, grouped by when they happen.

Name the trigger and its deadline

Write down what the event is, who set the date and how much budget comes with it. Once you know where a deadline came from, you also know how much room there is to move it.

Measure the cost of the current setup

Pull usage data from the current tool and add up the time agents and administrators spend keeping it running. The total is often bigger than the license line suggests: the L5 white paper on fragmented service operations estimates that licensing, integration, internal IT management and vendor services together run 2.7 to 4.1 times the license line, and our article on the total cost of owning an ITSM platform breaks that down cost by cost.

Test each inherited element

Take each field, form, rule, report and integration through the questions in the figure below, in order. Anything with no recorded use can be retired, and so can anything that serves no service level, policy or audit control. Where the platform has a standard way to do the job, use it; otherwise configure the element, or keep the system that already does it well.

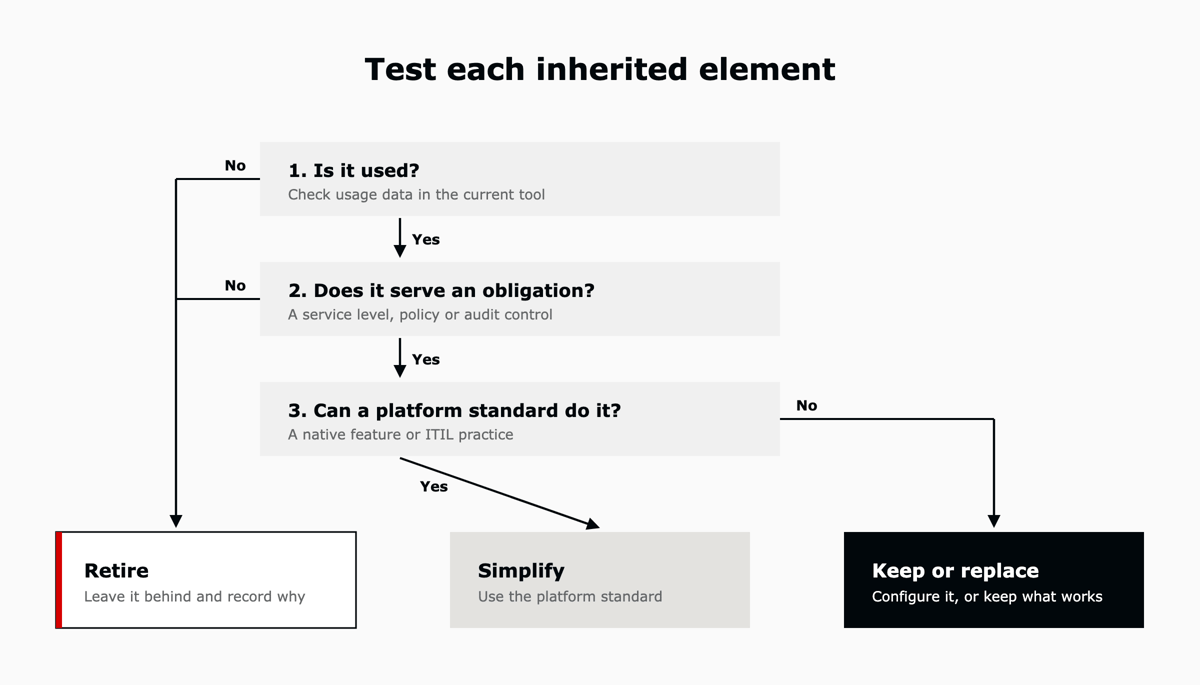

A decision tree with three questions for each inherited element: is it used, does it serve an obligation, and can a platform standard do it. The outcomes are retire, simplify, or keep or replace.
The three questions applied to each inherited element.

Go live on a reduced scope

Hold the date and shrink what goes live on it. Run the old tool alongside the new one for a fixed period, and agree the fallback before cutover.

Measure again after go-live

In the first months, check the new routine against its agreed service levels and adjust it while it is still easy to change.

Frequently asked questions

What is a trigger event in IT service management?

It is an event that forces a decision about your service platform, such as an acquisition, a carve-out, an audit finding, a license end date or a fixed go-live date. It comes with a deadline, and usually with the budget to meet it.

Is it safer to copy the old configuration first and redesign later?

Copying is quicker to specify, and it brings the old workarounds with it. Routines form soon after go-live, and changing them gets harder from then on. Cutting the scope lets you keep the date and leave the workarounds behind.

How do you decide which fields and forms to keep?

Start with usage data from the tool you have today, then take each element through three questions: is it used, does it serve a service level, policy or audit control, and can a platform standard do the job.

See where your service desk stands

If a renewal, an acquisition, an audit or a go-live date is coming up, the next step is knowing what the current setup costs and what is worth keeping. Book an assessment and walk away with a scorecard across five levels of AI maturity, a roadmap and a business case, in one week against a fixed scope.

L5 deploys and operates AI on purpose-built service management platforms, Zendesk, ClickUp, and Workday, for mid-market organizations, and stays accountable for what the system produces after go-live, every week.

Sources

  1. Tyre, M. J. and Orlikowski, W. J. (1994). Windows of Opportunity: Temporal Patterns of Technological Adaptation in Organizations. Organization Science 5(1), 98 to 118.
  2. PwC (November 2023). How expediting transition service agreement exits can unlock deal value.
  3. Saritasa (2025). 2025 State of Legacy Software Modernization Report, conducted by Researchscape. 504 U.S. IT professionals, May 2025; the barriers question was asked of the 299 whose organizations use legacy systems.
  4. Samuelson, W. and Zeckhauser, R. (1988). Status Quo Bias in Decision Making. Journal of Risk and Uncertainty 1, 7 to 59.
  5. Norton, M. I., Mochon, D. and Ariely, D. (2012). The IKEA effect: When labor leads to love. Journal of Consumer Psychology 22(3), 453 to 460.
  6. Lewin, K. (1947). Frontiers in Group Dynamics: Concept, Method and Reality in Social Science; Social Equilibria and Social Change. Human Relations 1(1), 5 to 41.
  7. Thoughtworks Technology Radar (2019 and 2020). Legacy migration feature parity (Hold).
  8. Pendo (2019). The 2019 Feature Adoption Report. 615 Pendo customer subscriptions.
  9. Ensono (September 2026). State of IT Modernization Report, survey of IT leaders in the US and UK.
  10. Protiviti (2023). SOX Compliance Survey. 564 audit and finance leaders.
  11. ITSM.tools (January 2026). Change enablement: standard, normal and emergency changes.
  12. Global Knowledge (January 2026). Announcing ITIL Version 5: Evolution in Action; ITSM.tools (February 2026), the ITIL Version 5 practices.
  13. Mechling, R. (2026). The Hidden Cost of Fragmented Service Operations. L5 white paper.
  14. L5 discovery and delivery calls, 2026: two clients and two prospects. Organizations are not named.
